Wedgewood ADU

2 Bed
1.5 Bath
600 sqft
attached
Testimonial image
Gallery image
Gallery image
View gallery
View All
ADU DesignArchitectural PlansStructural EngineeringTitle 24Civil EngineeringPlan Check FeesBuilding & Fire FeesWater & City FeesNotarizationCounty RecordingAgency CoordinationZoning VerificationProject ManagementCity InspectionsCertificate of OccupancyTurn-Key ConstructionPremium FinishesUtility ConnectionsWeekly UpdatesFinancingExterior DesignInterior DesignPre-ConstructionFinal WalkthroughWarranty SupportADU DesignArchitectural PlansStructural EngineeringTitle 24Civil EngineeringPlan Check FeesBuilding & Fire FeesWater & City FeesNotarizationCounty RecordingAgency CoordinationZoning VerificationProject ManagementCity InspectionsCertificate of OccupancyTurn-Key ConstructionPremium FinishesUtility ConnectionsWeekly UpdatesFinancingExterior DesignInterior DesignPre-ConstructionFinal WalkthroughWarranty Support

Designed to feel like home.

Wedgewood started as our Estate 600 and was customized for this home.

Project Timeline Overview

0 weeks

Plans

0 weeks

Permits

0 weeks

Construction

Week 1
Site Prep & Groundwork
Site Prep & Groundwork

Week 2
Foundation & Footings
Foundation & Footings

Week 3
Framing & Rough-Ins
Framing & Rough-Ins

Week 4
Windows, Doors & Exterior Shell
Windows, Doors & Exterior Shell
Week 5

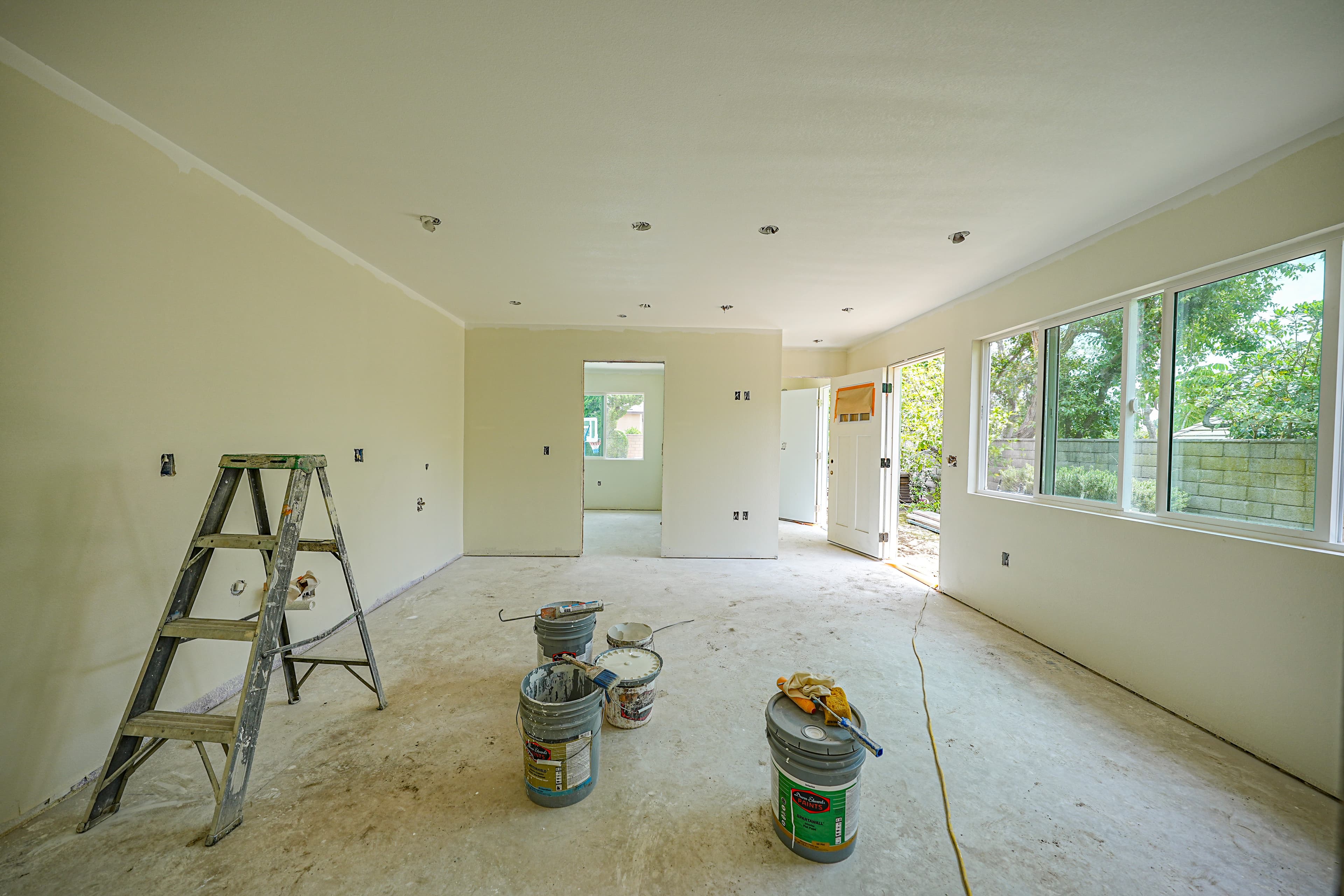

Insulation & Drywall
Insulation & Drywall

Week 6
Interior & Exterior Finish
Interior & Exterior Finish
Week 7
Cabinets & Countertops
Cabinets & Countertops
Week 8
Interior Touch-ups & Final Inspection
Interior Touch-ups & Final Inspection

Site work on this lot

No surprises. Here’s why.

Our Formal Property Analysis found all of this before they signed.

Step 1 of 2

Found before we started

Our architect and engineers checked this lot before we designed anything. Finding these early is how we avoid surprises during the build.

Attached ADU: At the FPA site visit, Jan 14, 2026

At the FPA site visit, Jan 14, 2026

Attached ADU

What we found during the FPA
The ADU attaches to the main house.
How finding it early helped
Planning the connection early let us design the shared wall, roofline and fire separation together.
What it meant for this homeowner
Two homes that look like one outside and stay safely separate inside.
Additional utility lengths (53 feet): Digging the utility lines, May 4, 2026

Digging the utility lines, May 4, 2026

Additional utility lengths (53 feet)

What we found during the FPA
Sewer, water and power lines had to run farther than usual.
How finding it early helped
We mapped the route and checked the sewer’s slope over that distance, then sized the pipe and wire for the length.
What it meant for this homeowner
The yard was dug once, and every line works the way it was planned.
Area drain re-routed: On site, May 5, 2026

On site, May 5, 2026

Area drain re-routed

What we found during the FPA
A drain line ran right where the ADU would sit.
How finding it early helped
Finding it early let us route the drain around the ADU on paper, before any digging.
What it meant for this homeowner
The crew dug once, and the yard still drains the way it should.
Pool fence to meet Upland code: At the FPA site visit, Jan 14, 2026

At the FPA site visit, Jan 14, 2026

Pool fence to meet Upland code

What we found during the FPA
Pool safety rules applied once a new home was added to the lot.
How finding it early helped
We designed the fence and gates to those rules from the start, so they were part of the plan, not a fix at the end.
What it meant for this homeowner
A safe pool area, and a final inspection without a holdup.
Sewer scope: At the FPA site visit, Jan 14, 2026

At the FPA site visit, Jan 14, 2026

Sewer scope

What we found during the FPA
The existing sewer line needed a camera check before the ADU could tie in.
How finding it early helped
The camera showed the line’s condition before we connected, so any repair was planned in, not found under a new yard.
What it meant for this homeowner
A sewer line ready for two homes, and a finished yard left alone.
Electrical load calculations: At the FPA site visit, Jan 14, 2026

At the FPA site visit, Jan 14, 2026

Electrical load calculations

What we found during the FPA
The electrical panel had to power two homes.
How finding it early helped
Our load calculation showed what the panel could carry, so any upgrade and the utility’s scheduling started early, not after the walls went up.
What it meant for this homeowner
Power for both homes from day one, with no wait on the utility.
  • Concrete cut and removed at the driveway and ADU: Cut through the driveway, May 4, 2026

    Cut through the driveway, May 4, 2026

    Concrete cut and removed at the driveway and ADU

  • Driveway concrete replaced at the cut: Concrete cut for the trench at one of our jobs

    Concrete cut for the trench at one of our jobs

    Driveway concrete replaced at the cut

    New concrete poured back where the old was cut.

Step 2 of 2

Finished to match the house

So the ADU looks like it belongs with the house.

The finished ADU
  • Tile roof, reusing existing tiles where possibleTile to match the house, on a roof built to hold it.
  • Stucco and foam trim around windows and front door
  • GuttersGutters that keep rainwater away from both homes.

Our team

Your team, from first visit to move-in.

One team. Every step.

  1. Plan

    • Serge MayerHead ArchitectWalks your lot and draws your plans. Civil engineering and surveying background.
  2. Permits

    • Mary CoonDirector of OperationsKeeps every step moving: permits, schedule, people.
    • Elsa TomasProject AdminYour updates and documents, in one place.
  3. Build

    • Tom GibsonDirector of Construction50+ years building. Sets how every ADU gets built.
    • Dusty GravattSenior Construction Mgr.Runs the job site and the crews.
    • Jose CervantesProject ManagerRuns your schedule from permit to move-in.
  4. Every step

    • Adam StewartPresident & FounderStands behind every build.
    • Edgar CureMarketing & Tech Mgr.Builds the tools that show you every number.

Formal Property Analysis (FPA)

Your lot has its own requirements. Find them before you build.

For Wedgewood, our architect and engineers checked 250+ things before anything was designed.

Wedgewood’s FPA250+ checks
  • Distance to the house and lot linesShared wall and roof designed as oneFound
  • Slope and drainageDrain routed around the ADUFound
  • Pool or spaFence and gates designed to codeFound
  • Sewer line conditionLine checked before the tie-inFound
  • Utility run lengthsRouted and sized before any diggingFound
  • Electrical panel sizePower for both homes, planned earlyFound

Also checked

  • Zoning and setbacks
  • Height and size limits
  • Soil and foundation
  • Water meter size
  • Fire department rules

And 230+ more on every lot

  • What your lot needs
  • A buildable solution
  • A proposal with no surprises
Book your FPA

$500, fully credited toward your build

Not ready? Start with a free office visit

Finishes in this home

Designed with purpose, finished with care.

Every finish and fixture is selected with intention.

  • Luxury Vinyl Plank - Malibu

    Flooring

    Malibu

  • Shaker Cabinets - Misty Gray

    Cabinets

    Misty Gray

  • Countertop - Calacatas Rocky

    Countertops

    Calacatas Rocky

  • Ceramic Tile - Bright White

    Shower tile

    Bright White

  • Cabinet Pulls - Satin Nickel

    Hardware

    Satin Nickel

  • Kitchen Faucet - Satin Nickel

    Kitchen faucet

    Satin Nickel

Projects with a similar approach

A selection of ADUs shaped by thoughtful planning, refined details, and spaces designed to live well.
